Deliverables

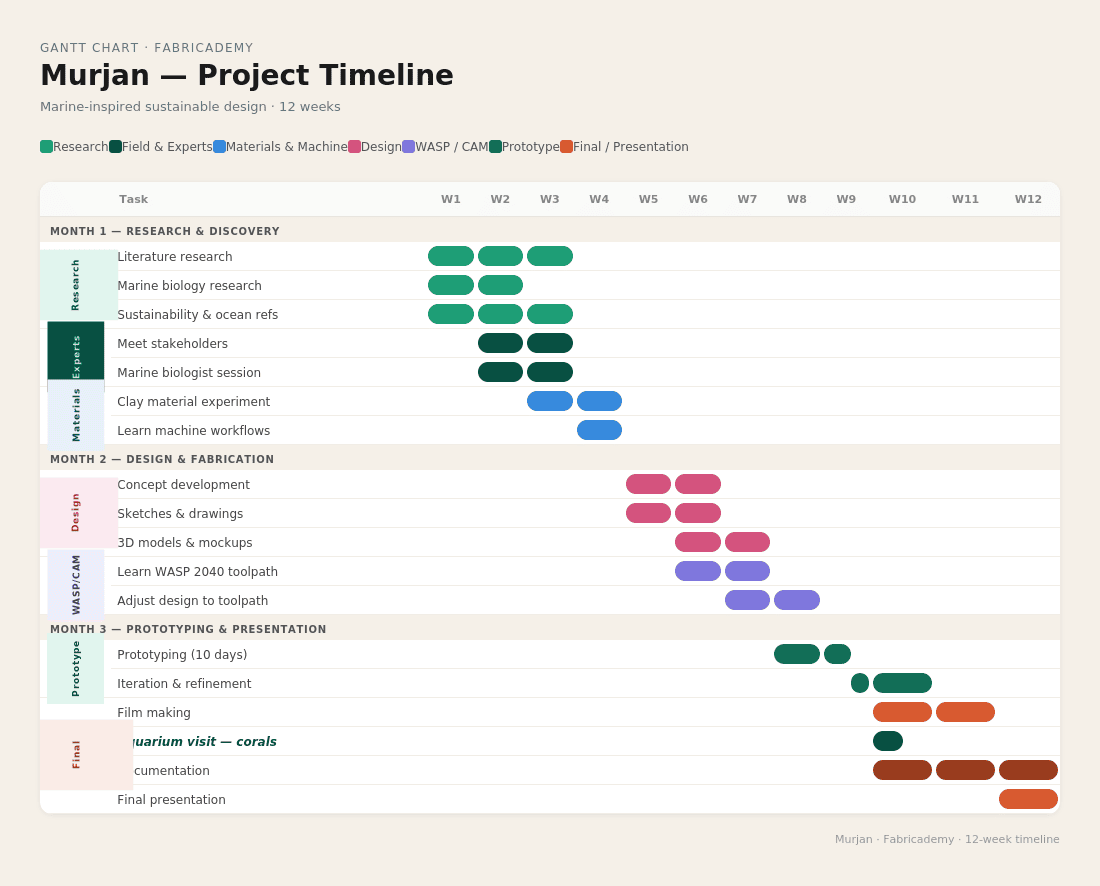

GANTT

BoM – Bill of Materials
Machines Used
| Machine / Tool |
Details |
Link |
Price (USD)/LAB |
| Wasp2040 clay 3d print |
WASP |
Link |
FROM THE LAB |
| 3D Printer |
ULTIMAKER |
Link |
LAB |
| Laser Cutter |
Trotec Speedy Series |
Link |
LAB |
Software Used
| Software |
Purpose |
Link |
Price |
| Rhinoceros |
3D Design |
Link |
Licensed (student version available) |
| Grasshopper |
Parametric modeling + generative plugins |
Link |
Integrated with Rhino |
| Simplify 3D |
slicing software for G-Code to WASP2040 |
Link |
Offered in lab |
| Adobe (Premiere Pro ) |
Video edit |
Link |
~$21/mo |
| After Effects |
video effects |
Link |
~$21/mo |
| Inkskape |
vectorize image |
Link |
free |
| Ultimaker Cura |
Slicing 3d Printer |
Link |
free |
For Video Editing
As i Made the video editing so these purchased shutters and sounds and Drone for my video edit .
| Material |
Description |
Price (USD) |
| Music |
Purchase copy write music |
$16 |
| Drone |
Aqaba shutter 16 seconds |
$79 |
| Adobe shutters |
sence with high resolutions for corals in aqaba |
~$24 |
| AI Geneative |
sence aligned with my storytelling |
$16 |
| Coral Aaquarium |
Specific PH + Red sea for planting corals in aquarium |
Free as a community support for researchers |
| --- |
|
|
The Clay + Firing
| Material |
Description |
Price (USD) |
| Dhana Clay |
natural Sand from south processed by me manually to became clay |
Free |
| Pink Clay (sama saket) |
commercial clay made from local clay material |
Provided by lab + purchase $15-17 |
| Italian Clay |
White Italian Clay |
Provided by the lab |
| clay Firing |
Using over on 1200 degree to turn to terracotta |
$50 |
| --- |
|
|
Presentations
Mid PDF Version
Open PDF in new tab
Final PDF Version
Open PDF in new tab
