Deliverables¶

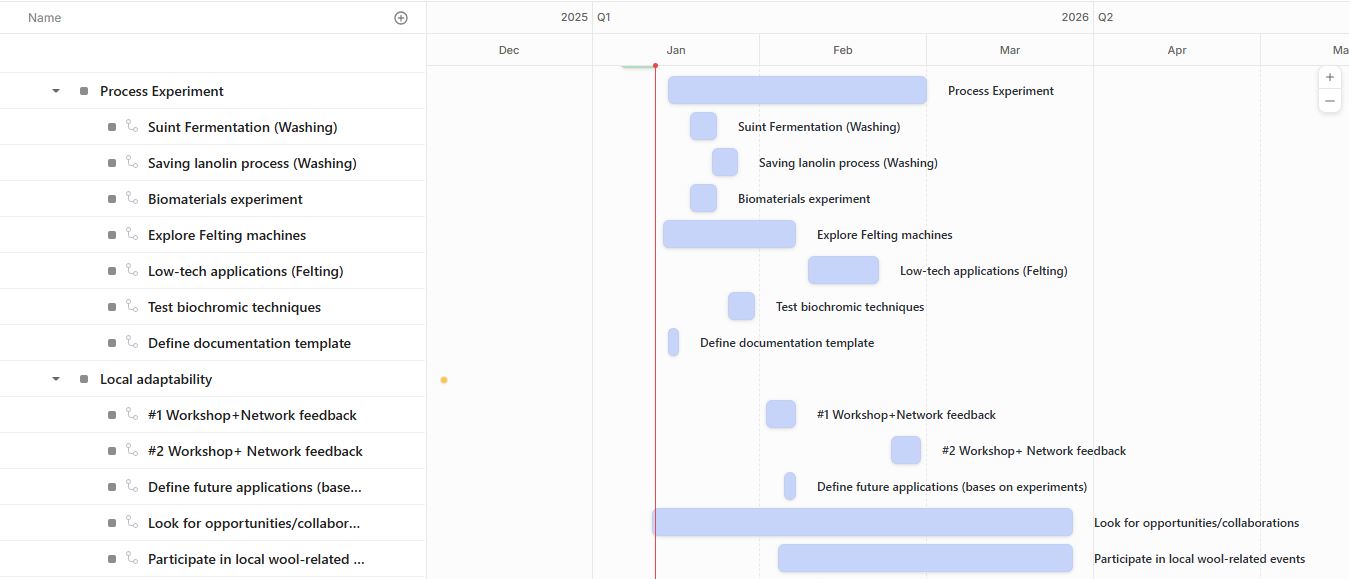

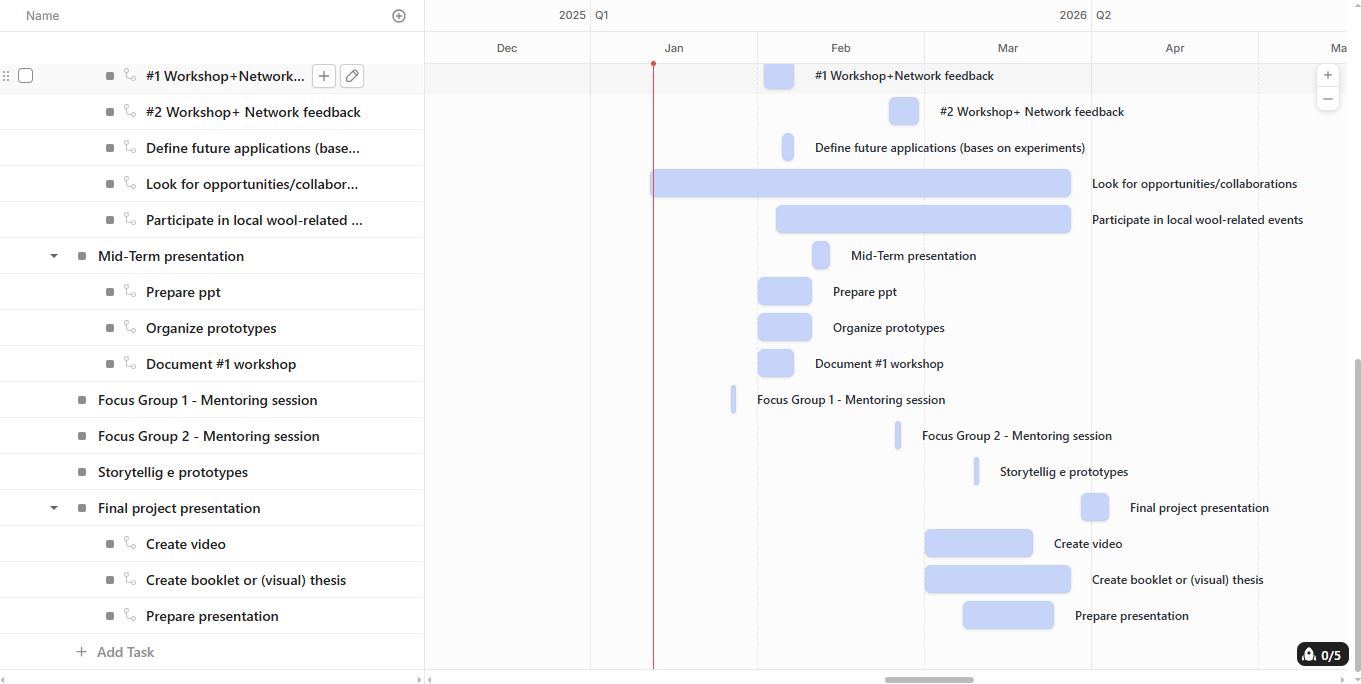

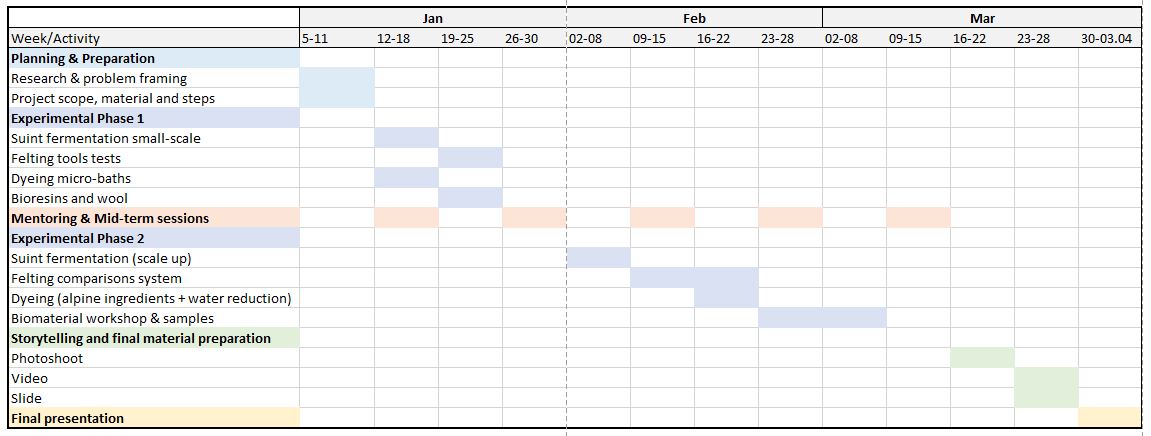

GANTT¶
Notes:
-
To track day-to-day activities, Google Calendar (select the time period corresponding to the project development phase).
-
For Gantt visualization, I initially tested Clickup, but I later reached platform limits and was required to upgrade to a paid plan to continue, despite it being presented as free. I encountered similar limitations with other tools.
BoM (bill of materials)¶
Suint Fermentation (Washing)¶
Small scale test
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 500g | Unwashed wool | 1€/kg | NA | available in the lab |
| 2.5-5L | Water | 0€ | NA | Wool-to-water ratio 1:5–1:10 |
| 1 | Stainless steel bain-marie | 145.00 € | Store link | available in the lab, using due to winter conditions |
| 1 | Thermometer | 5.99€ | Store link | available in the lab |
| 5-10 | pH strips | 22€ | Store | available in the lab |
| 1 pair | Protective gloves | 3€ (pack) | Store | available in the lab (optional) |
| 1 | Spoon | 3.99€ | Store | available in the lab, used as reference, needed for the lanolin process |
Scale up system
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 5kg | Unwashed wool | 1€/kg | NA | available in the lab |
| 70L | Rainwater | 0€ | NA | Collected in the lab |
| 1 | Stainless steel container (200L) | 145.00€ | Store | Available for free as a left-over from a beverage company (Pauline's contact) |
| 1 | Aquarium thermostat | 12.99€ | Store | Woolshed funds, ordered from a local company |
| 1 | Aquarium pump | 7.99€ | Store | Woolshed funds, ordered from a local company |
Washing machine system
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 1kg | Unwashed wool | 1€/kg | NA | available in the lab |
| 5L | Rainwater | 0€ | NA | Collected in the lab |
| 1 | Tectake compact washing machine | 150.00€ | Store | Available for free from Envie |
Biochromic (Coloring wool)¶
Micro-bath and contact dyeing
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 25g | Wool (washed, unwashed) | TBC | NA | available in the lab |
| 100g | Natural ingredients (coffee, curcuma, leaves, oak) | 2€ | NA | available in the lab or food recovery |
| 1.2L | Water | 0€ | NA | based on number of pieces |
| 5 | Bowls | 4€ | NA | available in the lab - per experiment as different fibers to test |
| 1 | Hot water kettle | 15€ | Store link | available in the lab |
Local ingredients and water-saving experiments
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 45g | Washed wool | 1 €/kg (unwashed price) | NA | available in the lab |
| 38g | Natural ingredients (coffee, curcuma, leaves, oak) | 2 € | NA | available in the lab or food recovery |
| 500ml | Water | 0 € | NA | per bath |
| 5 | Bowls | 4 € | NA | available in the lab, for ingredients preparation |
| 2 Small pots | 10€ each | Store link | Available in the lab | |
| 10g | Sulfate iron | 10€ | Store link | few grams used for some tests |
| 500ml | Vinegar | 9.99€ for 5L | Store link | available in the lab, easy to buy in any supermarket |
| 50g | Creme tartar | 23€ for 1 kg | Store link | Available in the lab |
| 250g | potassium aluminium sulfate | 10€ for 1 kg | Store link | Available in the lab |
Felting¶
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 500g | Washed and carded wool | 1€/kg (unwashed price) | NA | available in the lab |
| NA | Water | NA | NA | Also rainwater tested |
| 1 bar | Marseille soap | 4.5€ | Store link | Available in the lab |
| 1 | Hot water kettle | 15€ | Store link | available in the lab |
| 1 | Needle felting kit | 10€ | Store link | Available in the lab |
| 1/each | Low/medium/high tech tools for testing (sanding machine, rolling pin, etc.) | Depending on the product | NA | Available in the lab |
More details here.
Biomaterials¶
Wool Sheet (referring to 1 sheet)
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 10g | Unwashed wool | TBC | NA | available in the lab |
| 0.2–0.3 g | CMC | TBC | NA | available in the lab |
| 50ml | Water | 0 € | NA | adjust for consistency |
| 5g | Recycled paper pulp | 0 € | NA | shredded toilet paper works |
| 0.1 | Arabic gum | 5.99 € | Store link | available in the lab |
Bio-resins tests
| Qty | Description | Price | Link | Notes |
|---|---|---|---|---|
| 20g | Unwashed wool | TBC | NA | available in the lab |
| 100g | Food waste (banana peels, avocado peels) | 0 | NA | collected at home |
| 100ml | Water | 0 € | NA | adjust for consistency |
| few spoons | Binders (sugar, cornstarch, glycerin, alginate) | 1€ for the experiment | NA | available in the lab |
Alginate-wool biocomposite
All details in this page.
How-to: first proposal¶
For more details on step-by-step processes, visit the dedicated experiments pages.
Mentoring sessions¶
Support needed
I am seeking guidance from the Fabricademy network, both remotely and in-lab, on methodology (process and material testing), as well as facilitating workshops to gather meaningful feedback.
13/01/2026:
| Name | Comment |
|---|---|
| Anastasia | Recommendation to focus on medium-scale (lab-level) instead of small-scale |
27/01/2026:
| Name | Comment |
|---|---|
| Adele | "You have a strong process in place, already run some experiments and it's good you have engaded the Woolshed community. Keep going! " |
| Anastasia | 4 key priorities for each pilar. Washing: developing a DIY suint fermentation machine / Felting: scientific comparison between felting techniques (using the same amount of wool and the same amount of time, observing and documenting the results), artistic samples might be produced / Biomaterials: community workshop (alginate + wool + food-based powder ingredients), development of a workshop template and testing it with FR Woolshed for planning / Biochromes: research into traditional Alpine colours now considered cultural heritage; pigments can be purchased rather than foraged |
24/02/2026:
| Name | Comment |
|---|---|
| Adele | Run workshops on biomaterials within the wool community, involving wool producers. My personal motivation is clear: I want to work closely with people. |
| Anastasia | Use the "Place - Design - Make - Impact" model for storytelling, possibly referring to the seasonal cycles of the wool process. |
| Carolina | Seek funding for the project, as its technical and scientific aspects are well suited to R&D contexts. |
Mid term review¶
12/03/2026:
| Name | Comment |
|---|---|
| Becky | The project is strong, well-structured and making significant progress. To move it forward, it should integrate measurable results—particularly clear data demonstrating water savings and identifying where and how these gains occur throughout the process. This evidence could support future funding opportunities. Further development could include exploring market applications and cross-sector collaborations, as many textile innovations struggle to scale without clear demand. From an academic perspective, the project is close to becoming a publishable paper if supported by a clear evaluation framework, identified gains and proposed measurement methods approached from a designer’s standpoint. |
Storytelling¶
Narrative¶
The narrative of this project unfolds starting from its context: it has its roots in Sardinia and extends to France through the Woolshed project.
It begins by addressing the challenges of working with rustic wool and gradually focuses on the role of water as a central element within the research.
A more detailed section explores the four pillars of the project and the different roles water plays, including the experiments and observations developed throughout the process.
The storytelling then opens towards what’s next, a direction that is still evolving, and concludes with the wool community, which has been a fundamental source of learning and inspiration. Despite the challenges surrounding wool today, there is a shared commitment to valorising this resource.
Video¶
The final video combines testimonials, field documentation from wool-related journeys, and scenes from material experiments.
The testimonials were collected through voice notes, where participants were invited to share their personal experiences with wool. These were later gathered, edited, and carefully selected, shaping the structure and flow of the video.
Among them, one reflection on the future of wool emerged strongly and was chosen as a closing message of hope, envisioning a renewed role for wool as a material with multiple applications and deep ancestral roots, able to connect with people on an emotional level.
Initial video proposal
Final outcomes¶
The final presentation, along with the video and detailed project documentation, can be viewed in the Project page.
Images: Martina Muroni unless otherwise stated.
